The French mission at Amathus traced a thick Late Roman wall along the west terrace of the acropolis, and the excavation report on the Tombs of the Kings at Paphos began to appear in print with its first volume. In Nicosia, the builders of the new Cyprus Museum showed journalists round the site.

Map of Cyprus

This week's stories

  • Fieldwork
  • Books
  • Museums
  • Ground above 200, 500, 1,000 m

Sites on this map

  1. 1Amathus
  2. 2Nea Paphos
Places in this week's fieldwork, book and museum news: the acropolis of Amathus east of Limassol, the northern cemetery of Nea Paphos, and Nicosia.Modern coastline (OpenStreetMap) and relief (Copernicus DEM). Tap or hover a site for its name and page.

Fieldwork

Overhead photograph of an L-shaped excavation trench, with a broad band of packed rough stones running down its left side and bare earth floors to the right

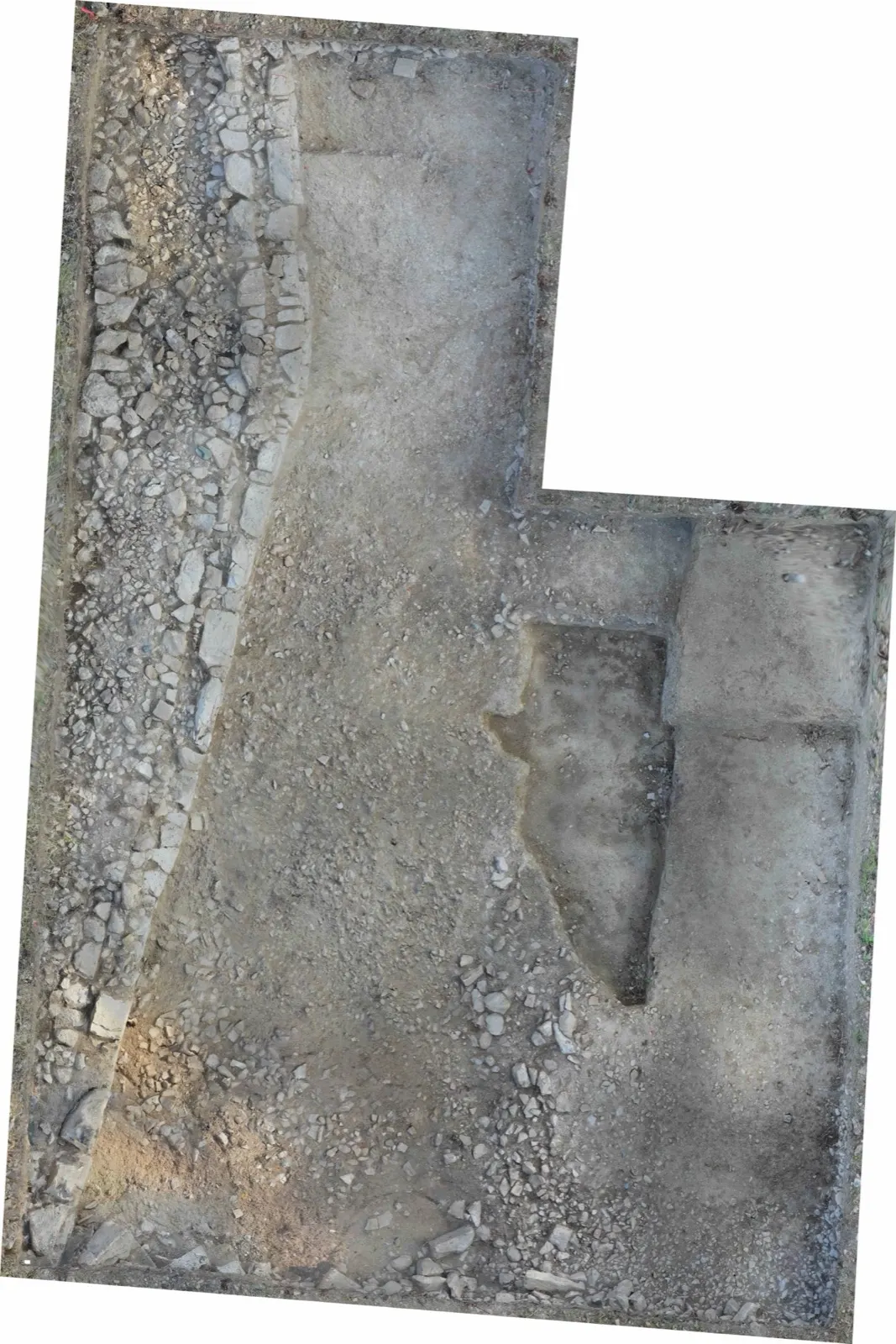

Trench 1 on the west terrace of the Amathus acropolis from the air, with the wall along its western side.Department of Antiquities, Cyprus

From 30 March to 24 April the French archaeological mission at Amathus dug a second season on the west terrace of the acropolis, the Department of Antiquities announced on 29 May. The work, directed by Dr Anna Cannavò of HiSoMA in Lyon for the French School at Athens, followed a geophysical survey in 2024 and a first season in 2025, which had found a short stretch of north–south wall and well-preserved Late Roman roof tiles.

This year Trench 1 was enlarged to 12 by 8 m. The wall runs along the natural edge of the terrace and turns slightly west at its southern end; it reaches 2 m in thickness and survives to about 50 cm on average. The team sees two probable phases, a first wall 135 cm thick later strengthened on its east face by a second row of large limestone blocks. To the east lay a floor partly paved with roof tiles, buried under fallen blocks, roof tiles and mudbrick from the wall's upper part. Transport amphorae and tiles date the wall and floor to the Late Roman period.

The Department reads the wall as probably defensive, protecting the upper acropolis and the basilica that took the place of the sanctuary of Aphrodite on the summit. A second trench, 5 by 5 m, on the northern edge of the terrace above an Archaic fortification wall the French mission excavated in 1976–1977, found no buildings but a deep fill rich in Iron Age material, including terracotta figurines and pottery in the Amathus style. Lower down, the stretch of city wall halfway up the acropolis, explored in 1975–1976 and again from 1988, has its main phase in the 6th century CE.

Books

On 27 May the Department released Volume I of the final publication of the Tombs of the Kings, the Ptolemaic cemetery north of Nea Paphos: Tombs of the Kings: The Ptolemaic Necropolis of Pafos, Volume I. Excavation Seasons 1977–1981 (ISBN 978-9963-36483-1), by Sophocles Hadjisavvas, who directed the Department's excavations there. Two of its chapters deal with Tomb 8, which, according to the Ministry, has been attributed on strong arguments to the burial of Ptolemy of Cyprus (80–58 BCE), who ruled the island until Rome annexed it. The book was to be presented at the A. G. Leventis Gallery in Nicosia on 3 June.

Museums

Cyfield, which is building the new home of the Cyprus Museum in Nicosia in a joint venture with Iacovou, took journalists round the site on 28 May. The building has a built area of 30,000 m² on five levels, two of them underground, and rests on 77 seismic isolators; the contractor had asked for 500 days beyond the completion date of 9 June 2026 (our brief on the later delay to 2028).
